714 Panels, Arbroath
Location: Arbroath, Scotland
Project Type: Commercial Solar PV Installation
System Size: 310.59kWp
Number of Panels: 714 x 435W Aiko Modules
Commissioned: March 2024
Project Duration: 3 weeks
Services Provided: Design, Planning, Procurement, Site Setup, Project Management, Commissioning, Handover
Background
The client is hotel based in Arbroath, Scotland, sought to reduce operational costs and improve its sustainability profile. With energy being a significant overhead, the company approached us to explore the feasibility of a rooftop Solar PV system to power their facility during daylight hours.
Objectives
- Offset daytime electricity usage with on-site renewable generation
- Reduce carbon footprint in line with the company’s net-zero goals
- Achieve ROI within 6-7 years
- Ensure minimal disruption to client and neighbours
Solution
Our team conducted a full feasibility assessment including:
- Roof structural survey
- Energy usage profile analysis
- Grid export and connection review
- Financial modelling and ROI forecasting

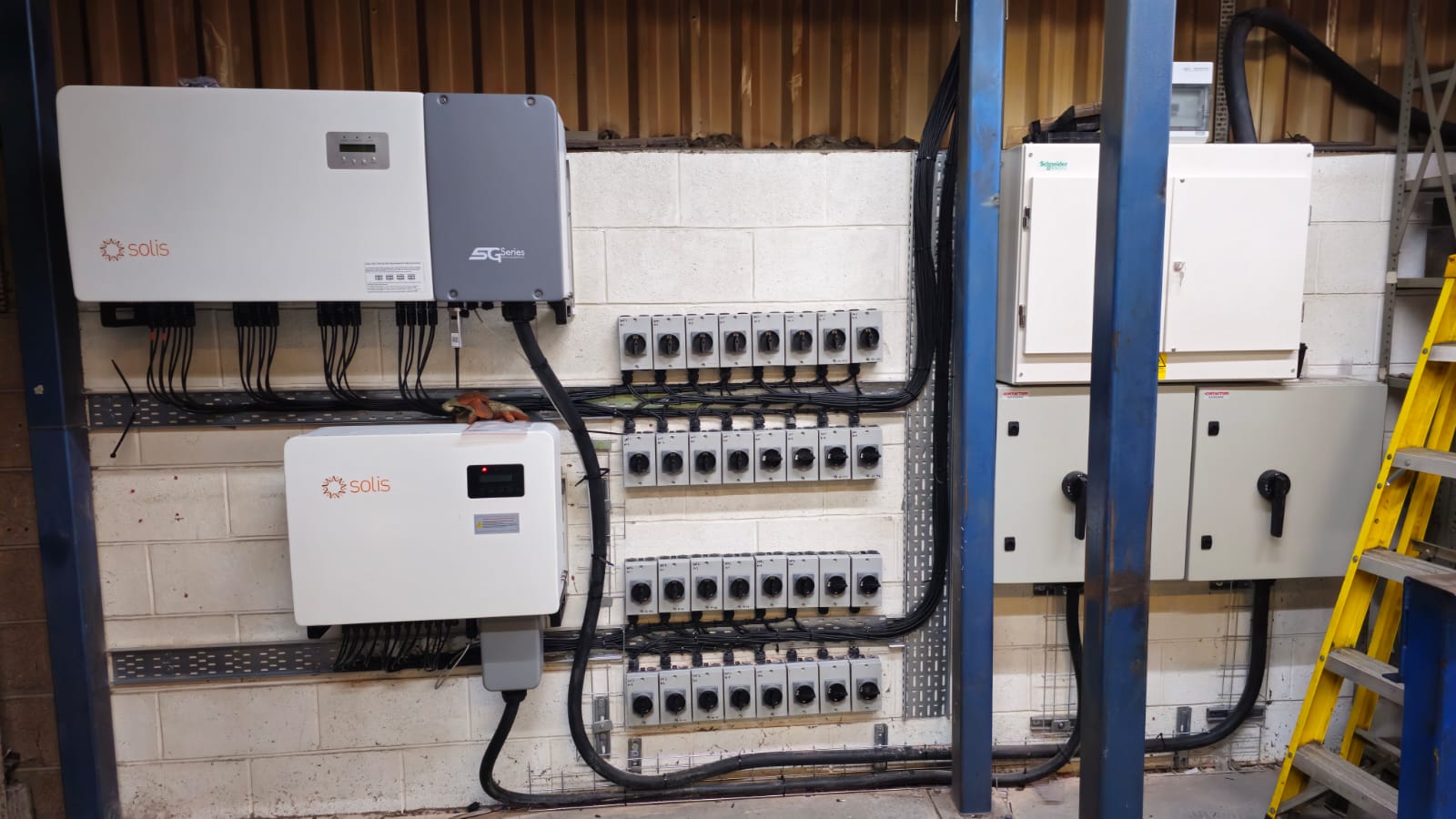

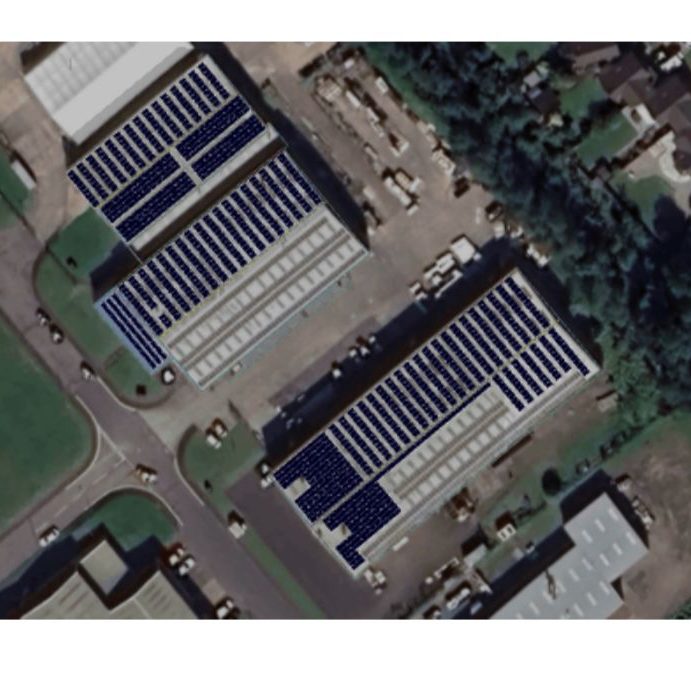

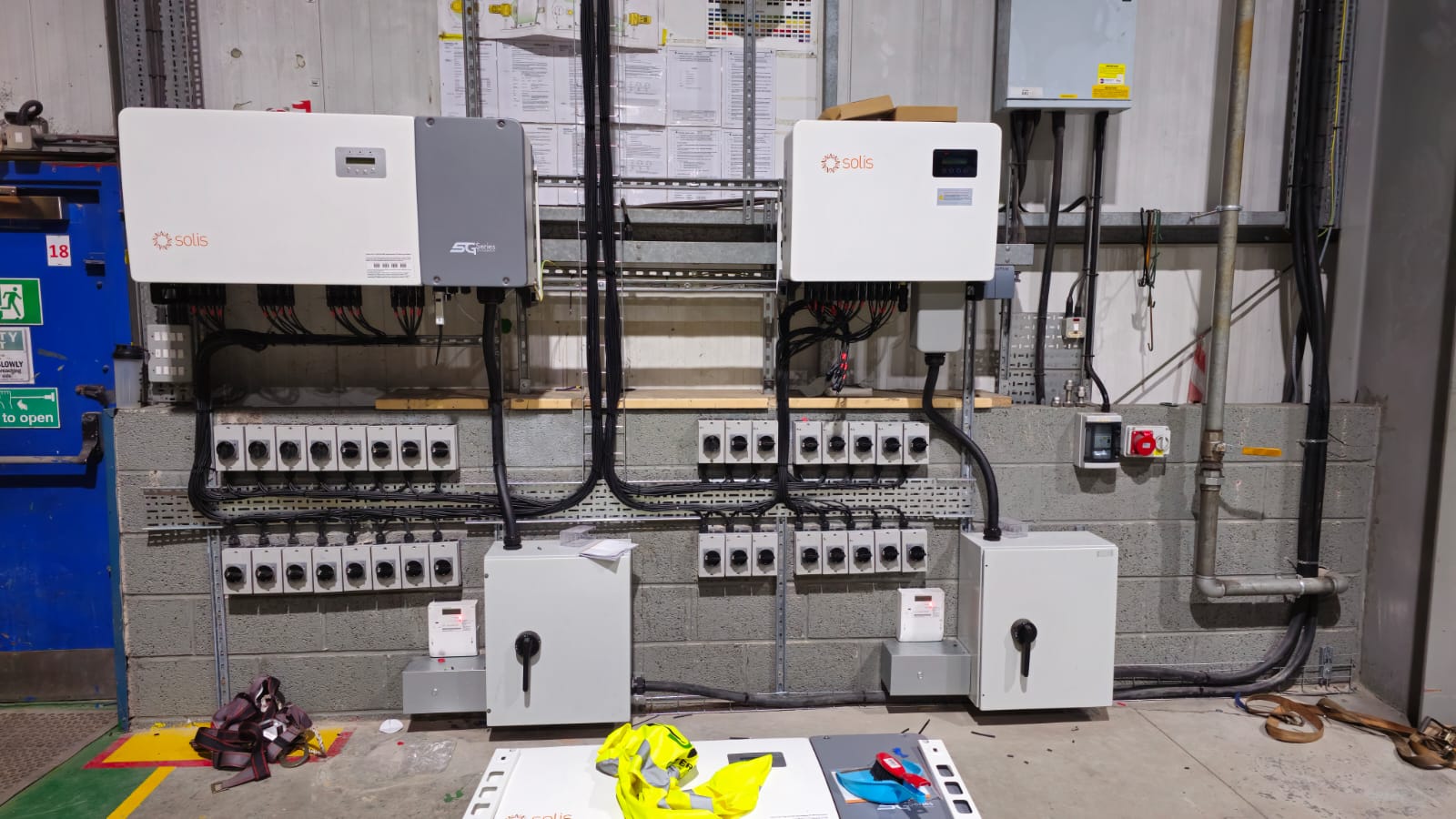

A full technical proposal was completed for a 310.59kWp rooftop Solar PV system using high-efficiency monocrystalline panels and Solis string inverters, optimally laid out across 3 buildings.
This client already had 45kWp installed on 2 of their buildings. With an imposed restriction by SPEN of 200kWp per building, we had to ensure the sites’ overall output did not exceed 400kWp.
Project Highlights

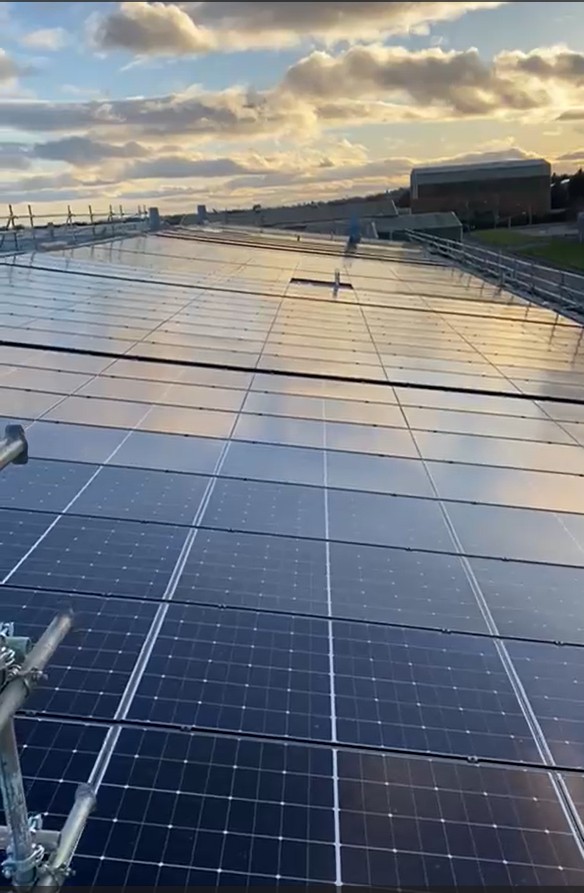

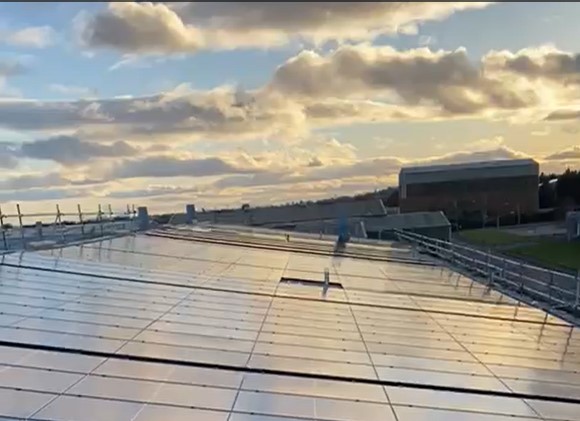

- Installation: 714 x 435W panels
- Expected Annual Generation: ~112,000kWh per meter
- Carbon Offset: ~28.4 tonnes CO₂ per year, per meter
- Self-Consumption Rate: 71%
- Payback Period: Estimated at 7 years 9 months
- Funding: Financed secured through a partner funder
Challenges
- Weather Delays: Typical Scottish weather impacted some install days; mitigated by adjusting crew allocation
- Grid Constraints: Local DNO required export limitation, solved using a G100-compliant export control system and limiting the site export to 400kWp
- Operational Continuity: Install was planned in phases to avoid interfering with production. Site shutdown was not required.
Outcome
The system was commissioned on time and within budget.
